By Steve Naale
Parys – Ngwathe Local Municipality is making strong strides in securing reliable water for its communities through a series of key infrastructure projects in Parys, Vredefort, Heilbron, Koppies, and Edenville.

The Municipal Water Infrastructure Status Core Report, released on 26 September 2025, highlights clear progress in fixing long-term water issues, bringing hope and stability to thousands of households. Under the steady guidance of Municipal Manager Dr Futhuli Mothamaha, these efforts show the municipality’s dedication to better service delivery and sustainable growth.
Recently cleared of all past allegations, Dr Mothamaha’s leadership shines as he drives a turnaround plan focused on accountability and community needs. With a fully funded budget and innovative strategies, Ngwathe is turning challenges into opportunities, creating jobs and boosting local economies along the way.
WATCH:
These projects are more than just pipes and towers – they represent a promise to future generations for clean, steady water that supports health, farming, and daily life. As Ngwathe celebrates these wins, residents can look forward to a brighter, more secure tomorrow.
MAJOR PROJECTS BRINGING WATER TO COMMUNITIES
The report details a range of upgrades, from near-complete pipelines to fresh starts on treatment works, all aimed at ending shortages and leaks.
WATCH:
In Parys, the replacement of a 15km asbestos water pipe under the Municipal Infrastructure Grant is 57% done. Most streets now connect to the network, with just one left. Contractor Sethabohle Trading is fixing small issues, and full handover is close.

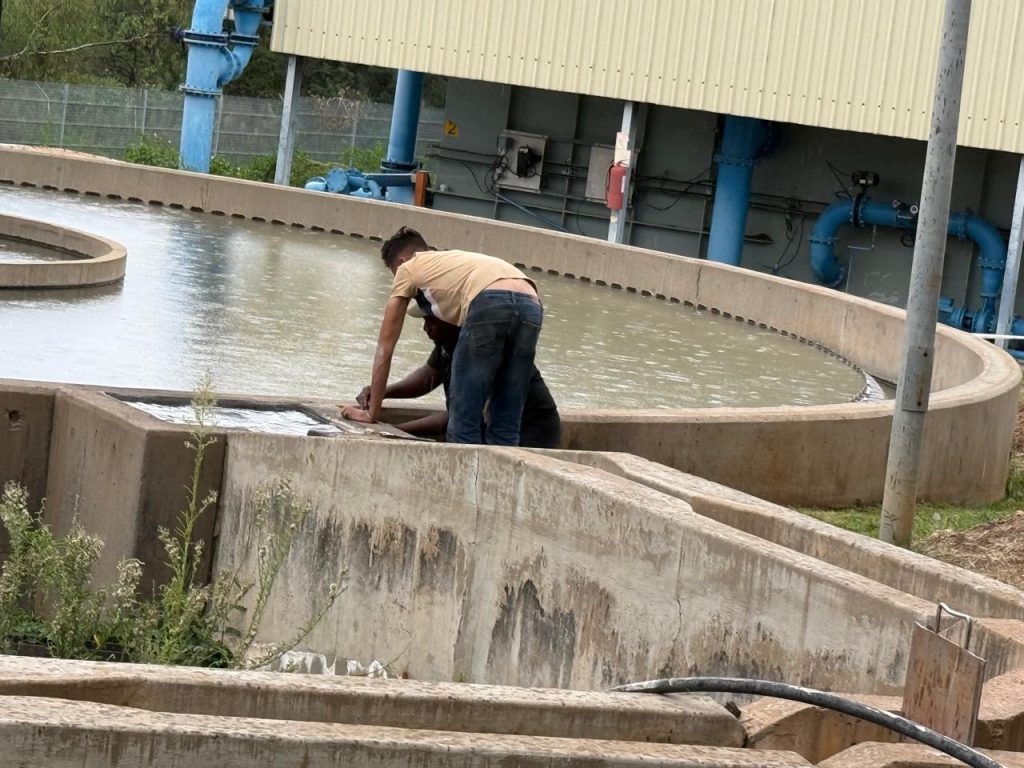

The refurbishment of the old Parys Water Treatment Works, funded by the Municipal Infrastructure Grant and Regional Bulk Infrastructure Grant, stands at 38% complete. After some consultant and contractor changes, new partner Zaroe Engineering will ramp up work in April 2026.

For Koppies and Edenville, the township secondary bulk water pipelines upgrade via the Regional Bulk Infrastructure Grant is 99% ready. Contractor Leano 87 Solutions is wrapping up home connections and leak repairs.
The bulk water supply pipeline linking Koppies to Edenville is 52% along, with fixes to faulty pipes underway.
In Heilbron and Phiritona, a new 5km pipeline and elevated tower project under the Water Services Infrastructure Grant kicked off recently, set to finish by March 2026. Contractor Iusa Technologies took over after a switch.

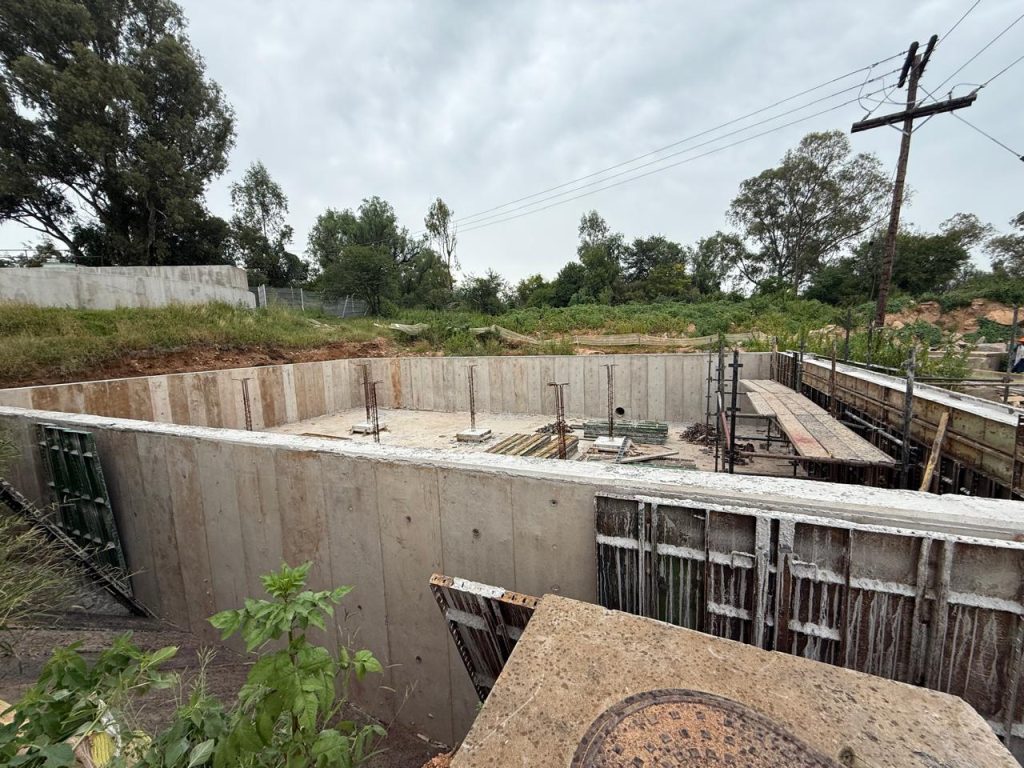

Vredefort sees the upgrading of its water treatment works and a new 4ML reservoir, funded by the Municipal Infrastructure Grant, just starting in September 2025.
CONTRACTOR ON SITE
Contractor MP Construction & Projects is on site, aiming for September 2026 completion.

These efforts tie into the Integrated Development Plan for 2025/26, which sets aside funds for ongoing upgrades like the Koppies to Edenville bulk water pipeline. This plan ensures projects meet community needs, promoting fair access and long-term reliability.
EXECUTIVE MAYOR’S VISION FOR DIGNITY & GROWTH
Executive Mayor Cllr Victoria De Beer-Mthombeni hailed the projects as a key win for residents who have waited years for better water.
“Water is a basic right, and as Ngwathe we are prioritising this above all else.
We have listened to residents from Parys, Vredefort, Heilbron, Koppies, and Edenville who have raised concerns for many years. These projects show that this administration is not only listening but acting,” she said.
She spotlighted the near-done Koppies-Kwakwatsi pipeline as proof of real delivery.
“To see 99% progress on a bulk pipeline is a milestone. It means that for thousands of residents, access to water is no longer a dream but a reality.”
The mayor linked these to wider goals. “Reliable water supply is key to unlocking growth in tourism, agriculture, and industry. This investment is not just about taps running — it’s about jobs, opportunities, and building sustainable communities.”
With a mayoral project launch in November 2025 strengthening service delivery, her leadership focuses on turning plans into action that lifts everyone.
MUNICIPAL MANAGER’S FOCUS ON MONITORING & SUSTAINABILITY
Dr Futhuli Mothamaha, recently cleared of all allegations, brings proven integrity to his role. He stressed close oversight.
“We are building sustainable infrastructure that will serve our communities for decades to come. While some projects have faced delays, the important thing is that corrective action has been taken, contractors are in place, and work is continuing,” he said.
Dr Mothamaha outlined his turnaround priorities, including performance checks and repairs to avoid future issues.
“Delivering water infrastructure is only the first step. We must maintain it to prevent future breakdowns. The municipality has put systems in place for ongoing monitoring and repairs, so that residents are not left to suffer again after many years without proper supply.”
His plan includes a comprehensive service delivery strategy, with the 2025/2026 budget of R2.099 billion – the first fully funded one – backing essentials like water and roads. This ensures steady progress, creating an environment for growth and investment.
A POSITIVE TURNING POINT FOR NGWATHE RESIDENTS
By 2026, with major works done, Ngwathe expects full water access across its towns. Areas like Mokwallo in Vredefort and Mapetla in Parys, hit hard by shortages, are already seeing relief. This progress marks a shift after underinvestment, fostering health, dignity, and opportunity.

The municipality’s renewed focus, under Dr Mothamaha and Mayor De Beer-Mthombeni, inspires confidence. With jobs from projects and better services, Ngwathe is building a thriving future where water flows reliably for all.
